2026 Nisswa Street Improvements

Project Overview

The City of Nisswa will be making improvements to the streets identified in the project area map below to improve public safety, property access, rideability, roadway strength, roadway drainage, roadway service life, and minimize pavement maintenance.

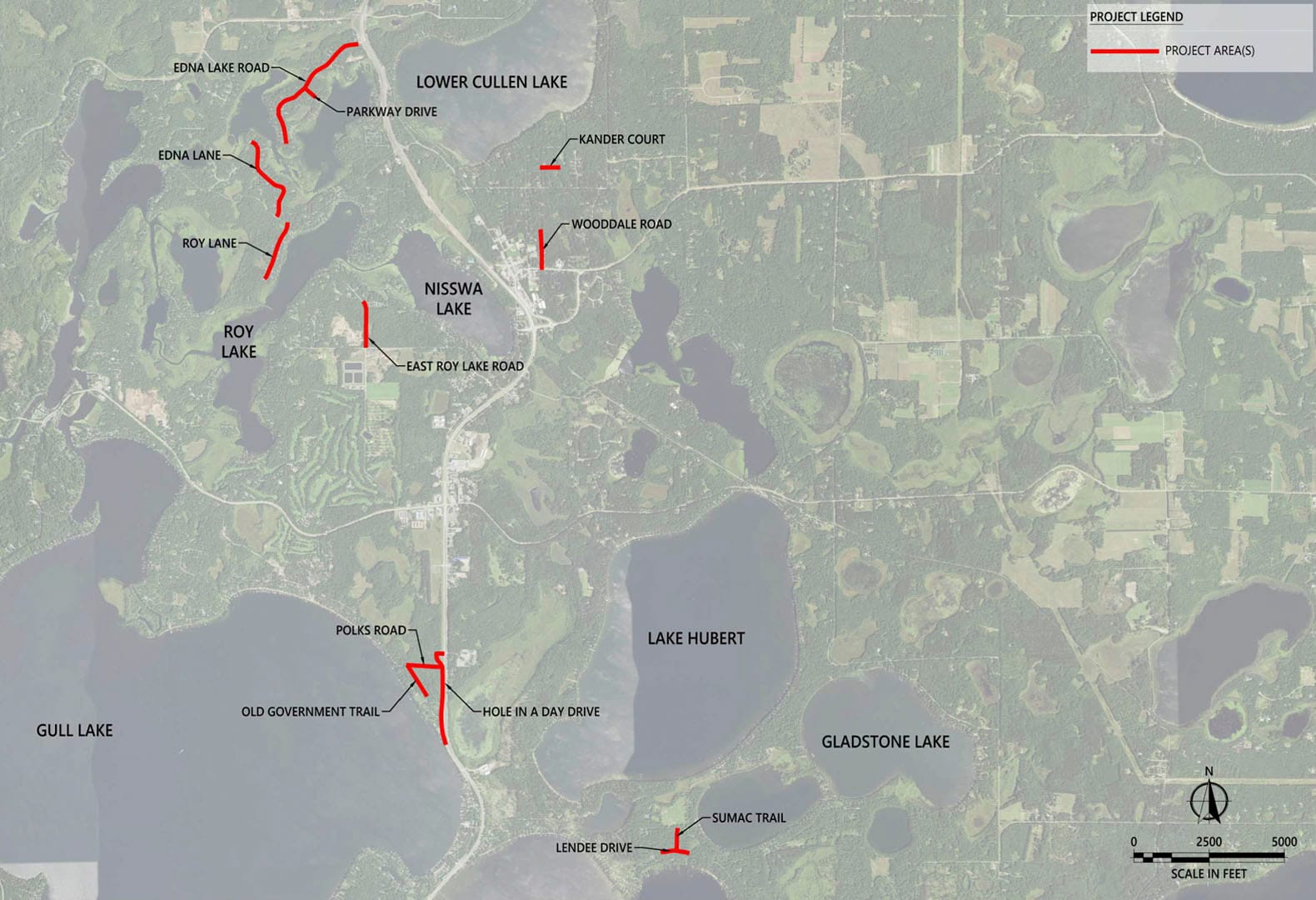

Nisswa Improvements Map

Project Timeline

9/5/2024

Notice to Residents — Road Survey and Utility Location

11/27/2024

Public Informational Meeting #1

2/25/2025

Council Retreat to discuss financing the 2026 street improvements and Right of Way acquisition

10/29/2025

Public Works Meeting, 60% Plan Review

12/3/2025

Public Informational Meeting #2, 90% Plan Review

1/20/2026

Authorization to Bid, 100% Plan Approval

2/17/2026

Public Hearing on Road Bond

2/26/2026

Bid Opening

3/17/2026

Street Improvements awarded to Anderson Brothers Construction for $2,618,974.95

3/24/2026

Anderson Brothers Construction Contract

4/8/2026

Notice to proceed with 2026 Nisswa Street Improvements

5/7/2026

Pre-Construction Conference Meeting

6/1/2026

Construction began with Hole in the Day Drive, Old Government Trail, and Polks Road

Construction moved to Edna Lake Road, Parkview Lane, and remaining 2026 Nisswa Streets

Construction Updates

10/5/2026

  • The concrete curb and gutter is taking longer than they expected and they did not start until Thursday because of the rain earlier in the week.
  • The contractor finished the curb and gutter on Saturday on Edna Lake Road. Concrete driveway aprons and grading the street will be completed after the curb and gutter.
  • The concrete curb and gutter construction are moving to Edna Lane and/or Roy Lane on Monday. They believe they will be done with curb and gutter on Wednesday. Hopefully, this means all concrete work.
  • The Contractor cut the communication line on Roy Lane at about station 296+00. The house on the east side of the road is without service. The Contractor notified the appropriate people to get it repaired. The property owner is aware of the problem and notified Charter/Spectrum.

9/25/2026

  • Concrete curb and gutter will begin on Edna Lake Road Wednesday September 30, 2026, with the completion of concrete work on all roads on Saturday October 3, 2026.
  • The contractor plans to work on Saturday October 3, 2026.  They will let us know which roads they will be working on Saturday after they get started.
  • Concrete work like bituminous paving is weather dependent.
  • Concrete driveway aprons and driveways will occur during this time.
  • Typically, cannot drive on the concrete until after a few days to allow the concrete to strengthen.
  • After the concrete work is complete the contractor will place aggregate base.
  • Paving will follow on October 12, 2026.

9/8/2026
Anderson Brothers will begin reclaiming on Edna Lake Road on Wednesday, September 9, 2026, for the 2026 Nisswa Street Improvement Project.

8/12/2026
The utility companies have been notified of the road work that is underway and are working to prevent outages. If you have any questions about your internet, power, gas, or phone service, or experience an outage please contact your utility company as this is the fastest way to get your questions answered or restore your service.  There are no planned outages at this time, however, they may occur unexpectedly if a line should be hit during construction activity. Thank you for your patience and understanding.

Questions regarding drainage, paving, mailboxes, or trees should be directed to Tom Blomer at City Hall 218-961-4244.

Grading work will begin on Roy Lane as early as 8/12/2026.  Utility relocation work is possible in this area.

Work on East Roy Lake Rd, Kander Court, Lendee Drive, and Sumac Trail is expected to begin by 8/17/2026. You will see staking by Widseth’s survey personnel 1st, followed by any necessary tree clearing by Young Excavating. Utility relocation work is possible in these areas.

Again, thank you for your patience and understanding while road improvements are underway.

7/28/2026
Anderson Brothers will begin construction on Edna Lake Road, Edna Lane, Parkway Drive, and Wooddale Road on August 3rd.
We are still waiting for ROW to be obtained for the project to begin on East Roy Lake Rd, Kander Court, Lendee Drive, Roy Lane, and Sumac Trl.

6/23/2026

We are waiting for ROW to be obtained for the project to begin on all roads.

  1. As of today, Old Government Trail, Polk Road, and Hole-in-the-Day Drive are finished.
  2. Bids for the project were received on February 26th. The low bidder is Anderson Brothers. An official presentation of the bids and Council acceptance was provided by Widseth at the March Council meeting.
  3. Maps for the project are posted in the Council Chambers for review. Please direct any comments or questions to Dave Reese or Tom Blomer concerning the project.
  4. 2026 Road Bond Timeline
    – May 4th, 2026. Begin Construction
    – Substantial Completion, October 15, 2026
    – November 30th, 2026, Complete Construction

East Roy Lake Road Information       East Roy Lake Road Plan
Edna Lake Road Information              Edna Lake Road Plan
Edna Lane Information                         Edna Lane Plan
Kander Court Information                   Kander Court Plan
Lendee Drive Information                    Lendee Drive Plan
Parkway Drive Information                 Parkway Drive Plan
Roy Lane Information                            Roy Lane Plan and Profile 2026
Sumac Trail Information                       Sumac Trail Plan
Wooddale Information                          Wooddale Plan
Polks Road Information                         Polks Road Plan
Old Government Trail Information     Old Government Trail Plan
Hole-In-The-Day Drive                             Hole-In-The-Day Drive Plan

9/10/2024
NOTIFICATION OF ROAD SURVEY, UTILITY LOCATION WORK, AND PUBLIC INFORMATION MEETING

Project Document Links

Project Contacts

Bill Westerberg

Bill Westerberg, PE

Project Engineer/Manager
Office Phone: 218-316-3651
Email: william.westerberg@widseth.com

Widseth

Dave Reese

Dave Reese, PE

City Engineer
Office Phone: 218-316-3629
Email: dave.reese@widseth.com

Widseth

Tom Blomer

Tom Blomer

Public Works Director
Office Phone: 218-961-4244
Email: tblomer@cityofnisswa.gov

City of Nisswa
